The facilities update project is now full speed ahead! We still remain on schedule and under budget. The following work is in the process of being completed this week:

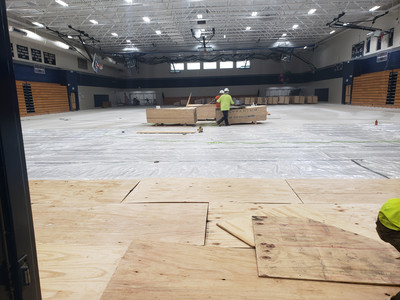

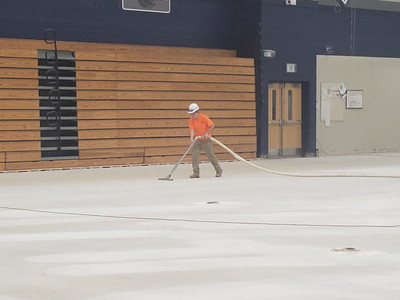

• High School main gym concrete base has been sanded and leveled. Beginning to apply the new moisture barrier as well as the plywood base. Maple flooring should begin to be installed in the next 2 weeks
• Room 311, the new science room, is getting the plumbing installed as of today
• The new auxiliary gym walls are going up nicely this week
• Footings for new gym are completely installed
• The TechEd addition walls are now up. Waiting on steel roofing materials to get on site now.

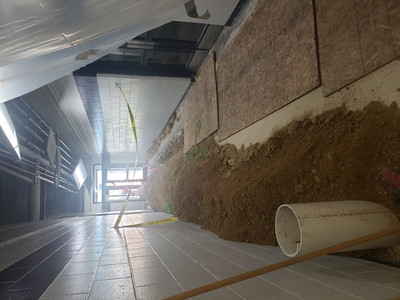

• Drain piping is being placed in the weight room corridor that will eventually connect to the new gym addition.
• New doorway was created for access to the Metal/Auto Shop from the Cad Lab.

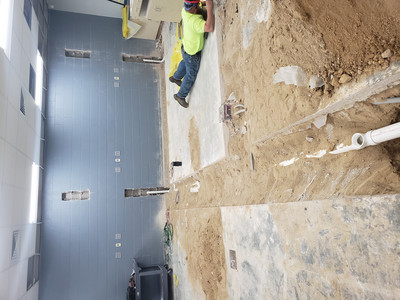

• Ag/Shop plumbing drains being installed.

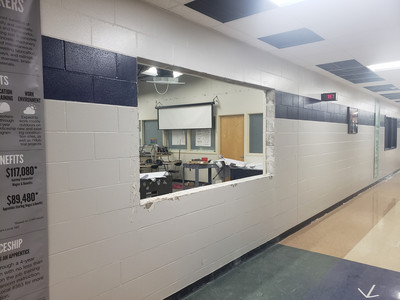

• Window removed from 2D-Art/Computer Lab
• Phase 1 of the Capital Maintenance projects are all doing great and ahead of schedule.
